Policy Brief, 2025-26

Murray–Darling Basin water recovery

Environment and Energy

Author

Science, Technology, Environment and Resources section

Go to section

Issue

The Australian Government has invested significant resources to implement water reforms in the Murray–Darling Basin (MDB) through the Basin Plan 2012 (Basin Plan). The reforms aim to achieve a healthy and resilient river system that supports communities, industries and ecosystems.

Key elements of the Basin Plan include water resource planning, First Nations water interests, monitoring and compliance, and water markets and trade. However, ‘[a]t its heart’, the plan sets the amount of water that can be taken from the Basin each year, while leaving enough to ensure a healthy environment.

Central to this are several water recovery targets to ‘reset the balance’ between consumptive use and environmental water. However, significant progress is needed to reach the targets and risks remain to full implementation of the plan.

Key points

  • The Basin Plan aims to recover 3,200 gigalitres per year (GL/y) of surface water and 38.45 GL/y of groundwater for environmental use through several targets.
  • In August 2023, the Australian and most Basin governments (NSW, Qld, SA and the ACT; excluding Vic) agreed to deliver the plan in full.
  • The Australian Parliament passed amendments in December 2023 to increase water recovery options and extend timeframes, with full implementation due by the end of 2027. The government also re-prioritised voluntary water purchases.
  • During the 48th Parliament, the first Basin Plan Review will be completed and decisions are likely on future management, programs and funding.

Context

The MDB is Australia’s largest river system (Figure 1), home to 2.4 million people and more than 50 First Nations. The Basin provides drinking water to over 3.4 million people and supports multiple industries, including nearly half of Australia’s irrigated agricultural production and a valuable tourism industry. It also sustains diverse ecosystems, including internationally significant wetlands.

However, the MDB is one of the world’s driest river systems, with variable rainfall and high evaporation. It is extensively modified and managed to ensure year-round water availability, particularly in the southern Basin. This has led to water overuse and declining river system health, which is compounded during drought.

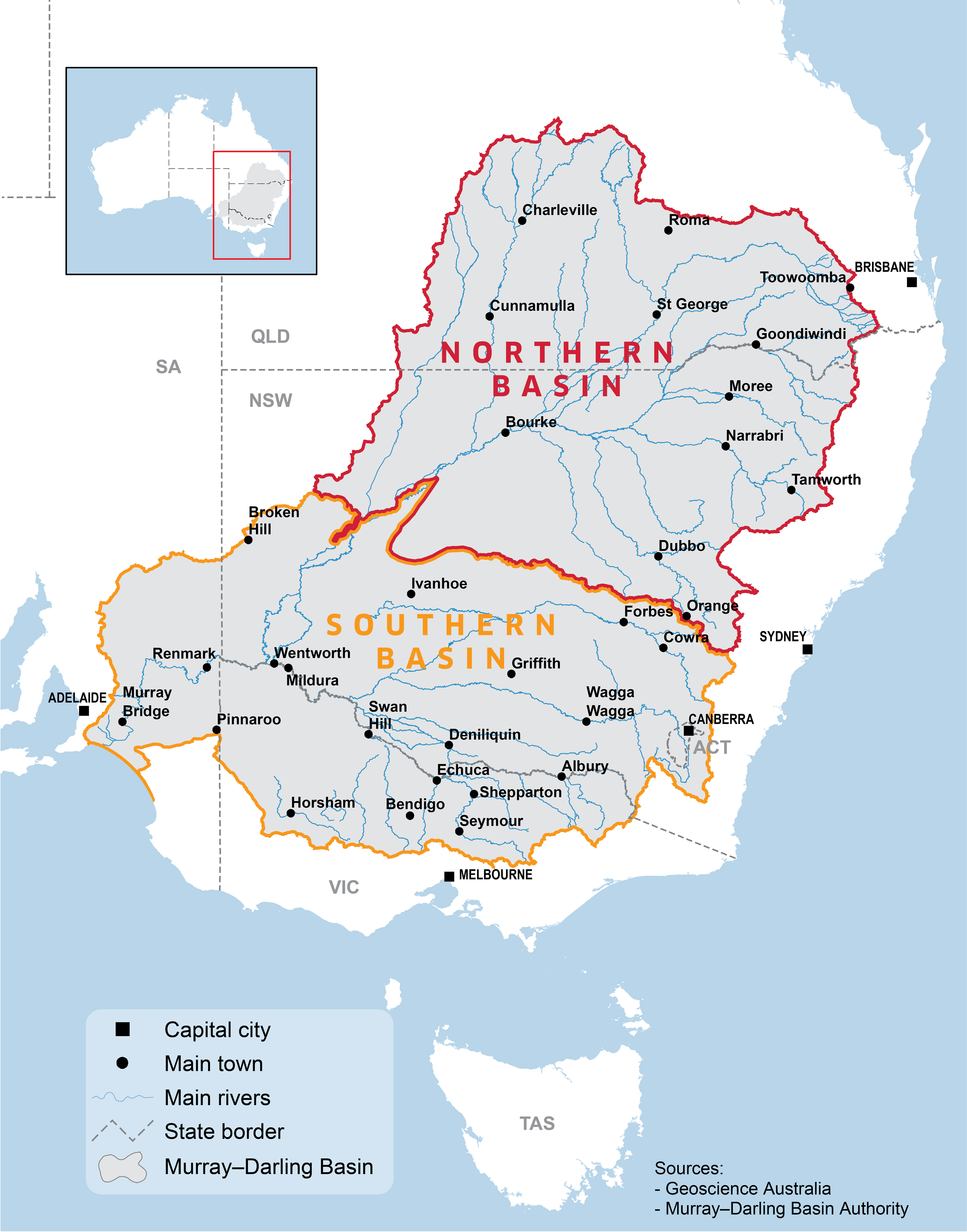

Figure 1              Murray–Darling Basin map

Source: Basin location, Murray–Darling Basin Authority Canberra, 2025, https://www.mdba.gov.au/basin/basin-location. CC BY 4.0

The Basin Plan and Restoring our Rivers amendments

The Water Act 2007 and Basin Plan provide the legal framework for sustainable water use in the interests of the MDB as a whole. The plan is designed to address fundamental challenges, including declining water quality and ecosystem health, inefficient water use and over-allocation.

It aims to recover the equivalent of 3,200 GL/y of surface water for environmental use through several targets (Figure 2). This includes the 2,075 GL/y bridging the gap target, as well as an additional 450 GL/y to achieve enhanced environmental outcomes. To reach these targets, the Australian Government must recover water entitlements from existing users. Additional water recovery targets are to be met through infrastructure projects and enhanced water management implemented by the Basin governments.

However, recovery has been challenged by competing social, economic and environmental interests.

In July 2023, the MDB Authority (MDBA) advised that ‘full implementation of the Basin Plan will not be possible by [the original statutory deadline of] 30 June 2024 under the current settings’ (p. 2). In response, the Australian and Basin governments (excluding Victoria) signed the Agreement to Deliver the Basin Plan in Full. In December 2023, the Water Amendment (Restoring Our Rivers) Act 2023 (RoR Act) was enacted, giving effect to the agreement by increasing options for water recovery and extending timeframes for delivering the plan to December 2027. However, ‘risks to full Basin Plan implementation remain’ (p. 2), including significant progress still required to reach the targets (Figure 3).

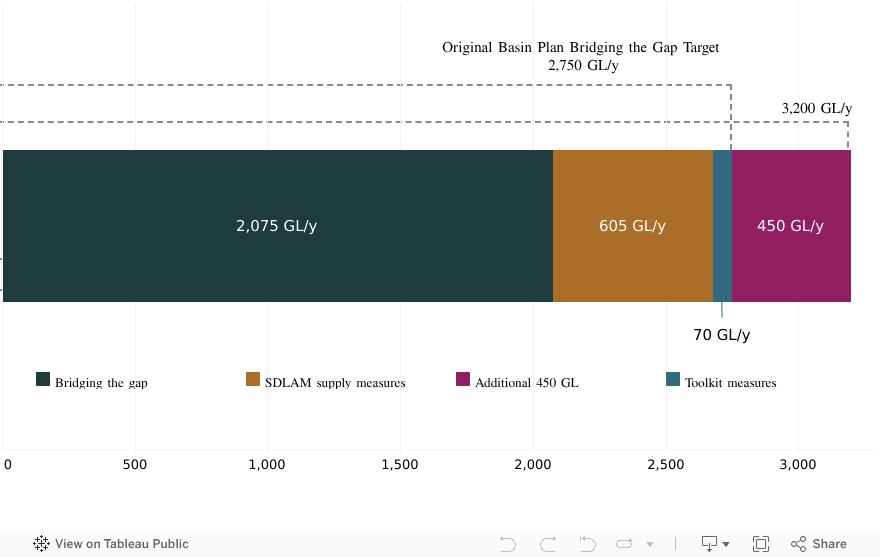

Figure 2              Basin Plan surface water recovery targets

Source: Adapted from Figure 1, Productivity Commission (PC), Murray–Darling Basin Plan: implementation review 2023, Inquiry report, 103, (Canberra: PC, 2023), 4.

Figure 3              Progress and remaining recovery of Basin Plan surface water recovery targets

Sources: Department of Climate Change, Energy, the Environment and Water (DCCEEW), Surface water recovery required under the Basin Plan including the Sustainable Diversion Limit Adjustment Mechanism and 450 GL for enhanced environmental outcomes as at 31 March 2025, (DCCEEW, n.d.); MDBA, Sustainable Diversion Limit Adjustment Mechanism: 2023 assurance report, (Canberra: MDBA, July 2023), 36; Adapted from Figure 3, PC, Murray–Darling Basin Plan: implementation review 2023, 8.

Water recovery targets

Bridging the gap targets

To ‘bridge the gap’ from historical to sustainable water use, the Basin Plan set sustainable diversion limits (SDLs). As pre-Basin Plan use exceeded the SDLs, water recovery is required. The current surface water recovery target is 2,075 GL/y, with a groundwater target of 38.45 GL/y (Figure 2).

Two main mechanisms are used to meet these targets: voluntary water entitlement purchases (‘buybacks’) and irrigation infrastructure investment. Evidence suggests water purchases are ‘by far the quickest and most cost-effective way’ to recover water (p. 92). However, reduced water consumption can have negative socio-economic impacts in some communities, particularly those that are small, remote, and reliant on irrigated agriculture (pp. 22, 43). Some irrigators, regional communities, and the NSW and Victorian governments strongly oppose water purchases.

Key developments

In February 2023, the Australian Government released its framework for recovering the remaining bridging the gap target, primarily through water purchases ‘in the absence of technically feasible, viable and value for money infrastructure projects’ (p. 1). It also announced the first water purchasing open tender since 2015, followed by a second tender in 2024 and recovery of the full target in the ACT.

This was in contrast to the previous government’s 2020 commitment to no further water purchasing, and was enabled by the RoR Act (by repealing a 2015 cap on Commonwealth surface water purchases).

Additional 450 GL target

The Water Act 2007 and Basin Plan aim to recover an additional 450 GL/y for enhanced environmental outcomes, through the $1.775 billion Water for the Environment Special Account (WESA), established in 2014.

Key developments and expectations

Before the RoR Act, options for recovering this target were constrained to efficiency measures with strict socio-economic criteria. However, to the end of June 2024, only 26 GL/y were recovered through the WESA. The RoR Act expanded recovery options and enabled significant changes in the water recovery strategy. It also extended the 450 GL target deadline to 31 December 2027.

Released in July 2024, the Restoring our rivers framework established the government’s intent to achieve the 450 GL target by also pursuing water purchases, land and water partnerships and reallocating over-recoveries (pp. 11–13). It includes a community adjustment assistance program to minimise socio‑economic impacts.

In 2024, the government opened the first water purchase open tender for the additional 450 GL target, followed by 2 expressions of interest. The Minister for Water also reallocated 78.2 GL/y of over-recoveries to the target in February 2025 (p. 1).

The Australian Government plans to recover around half of the remaining target by the end of 2025, primarily through water purchases. However, this approach could create ‘significant disruption to water markets’ (p. 82), with the magnitude of expected impacts on water prices and production value correlated with recovery volumes.

In June 2024, the Government released an addendum to the 2012 Basin Plan Regulation Impact Statement, noting positive and negative socio-economic implications for different communities (p. 5). ABARES also released reports assessing the impacts of further water recovery in the southern Basin, and Basin communities’ vulnerability and adaptive capacity to water availability changes.

The cost of recovering the full 450 GL is expected to exceed the existing WESA budget (p. 69). The third statutory WESA review, assessing recovery progress and feasibility, is due by 30 September 2025.

Sustainable Diversion Limit Adjustment Mechanism supply measures

The Basin Plan includes a mechanism to adjust the bridging the gap target (Sustainable Diversion Limit Adjustment Mechanism (SDLAM)). In 2018, the SDLAM was enacted to reduce the target by 605 GL/y in the southern Basin, provided Basin governments implement approved supply measures. The current bridging the gap surface water recovery target relies on these supply measures being completed.

Key developments and expectations

The RoR Act extended the deadline for completion of supply measures to 31 December 2026.

To date, 13 supply measures are complete, contributing an estimated 290 GL/y of the full 605 GL/y SDLAM adjustment (pp. 36–42). Another 10 are likely to be completed, with the remaining 12 unlikely to be fully delivered by the new deadline (p. 2). The RoR Act also enabled Basin governments to propose new supply measures. In June 2025, 3 new supply measures were agreed to be progressed. Until 30 June 2026, the Australian Government may withdraw measures it considers no longer viable.

The MDBA must reconcile the full SDLAM adjustment and actual outcomes of implemented supply measures by 31 December 2026 (p. 3). If measures are not completed, additional water must be recovered. A significant shortfall at SDLAM reconciliation is considered a ‘strong possibility’ (p. 82).

Northern Basin toolkit measures

In 2018, the Basin Plan was amended to reduce the bridging the gap target in the northern Basin by 70 GL/y. Informed by the Northern Basin review, the MDBA recommended this on the basis that ‘toolkit measures’ would be implemented.

In August 2019, Basin governments agreed to deliver 6 toolkit measures (pp. 31–36), including 11 infrastructure projects relating to environmental works and constraints removal.

Unlike SDLAM supply measures, toolkit measures do not require equivalent environmental outcomes or reconciliation under the Basin Plan. However, they are still ‘essential’ to resetting the balance (p. 4).

Key developments and expectations

Basin governments have agreed to extend the deadline for completion of toolkit infrastructure projects to 31 December 2026.

In October 2024, the Inspector-General of Water Compliance announced an inquiry into the toolkit, noting ‘little substantive progress in the last six years on implementing several of the Toolkit measures, particularly those involving critical infrastructure works’. The inquiry report is expected in mid-2025.

Constraints measures

The implementation of constraints measures is critical to achieving the enhanced environmental outcomes of the additional 450 GL, and the SDLAM and toolkit measures.

Basin governments have agreed to implement 7 constraints measures (5 are supply measures requiring SDLAM reconciliation and one is a toolkit measure). These are complex projects (pp. 15, 27), with significant challenges around social licence and landholder agreement (pp. 88–89).

Key developments and expectations

In December 2024, the MDBA published the Constraints relaxation implementation roadmap, which noted little chance of completing constraints measures by the new deadlines. It advocated for a new Basin-wide 10-year constraints relaxation program (pp. 27–30), as recommended by the Productivity Commission (p. 88) and SDLAM measures independent review (p. 3).

Conclusion

Over the next 3 years, several reviews will be finalised and significant decisions are expected on future MDB management, funding and programs.

In 2026, the MDBA will deliver the first statutory Basin Plan Review, which may prompt amendments to the plan. Several key reports informing the review will be published in 2025.

Currently, most federal funding for MDB water reform terminates in 2027–28. In addition to water recovery programs, this includes other important aspects of Basin Plan implementation.

This Parliament will likely need to consider the next steps for water policy and management in the Basin, building on significant past reforms, investment and efforts to achieve a healthy and resilient MDB system.
